Target vs Actual Test Execution

  • Introduction

  • Generate Report

  • View Reports

    • (A) Target Completion Date Report

    • (B) Execution Velocity Report

    • (C) Execution Planned Date

  • Share Target vs Actual Report

Introduction

The Target vs Actual Execution report enables users to see the execution progress or target completion date for the target execution.

Target vs Actual Execution report under the Test Execution Reports helps QA Managers understand the current test execution progress against the targeted execution to achieve the timeline. You can generate reports for the following calculation approaches:

  • Target Completion Date: For the specified duration, the report displays the Planned Test Execution Rate, Current Test Execution Rate, and Required Test Execution Rate to meet the release timelines. The report displays a Line Chart that indicates the execution progress during a particular sprint/period. It helps leads/managers review the current progress of test execution against the target test execution and make decisions regarding resource allocation/task distribution to achieve the target.

  • Execution Velocity: The Execution Velocity helps QA Managers measure how fast the test executions are performed compared to the set target. For the specified start date and per-day test execution velocity, the report displays the Planned Completion Date and current Test Execution Velocity. It calculates the Test Execution completion date based on the Current Test Execution Velocity.

  • Execution Planned Date: The Planned Date Graph displays the count of executions based on the planned execution for that specific day. The graph is cumulative, showing the total executions planned to date. When hovering over the counts, users can see the planned executions for that day and the overall total. This option exclusively considers test executions with planned dates falling between the Planned Execution Start Date and the Planned Execution End Date.

The generated cumulative line chart displays the count of Planned Test Executions and Actual Test Executions.

Generate Report

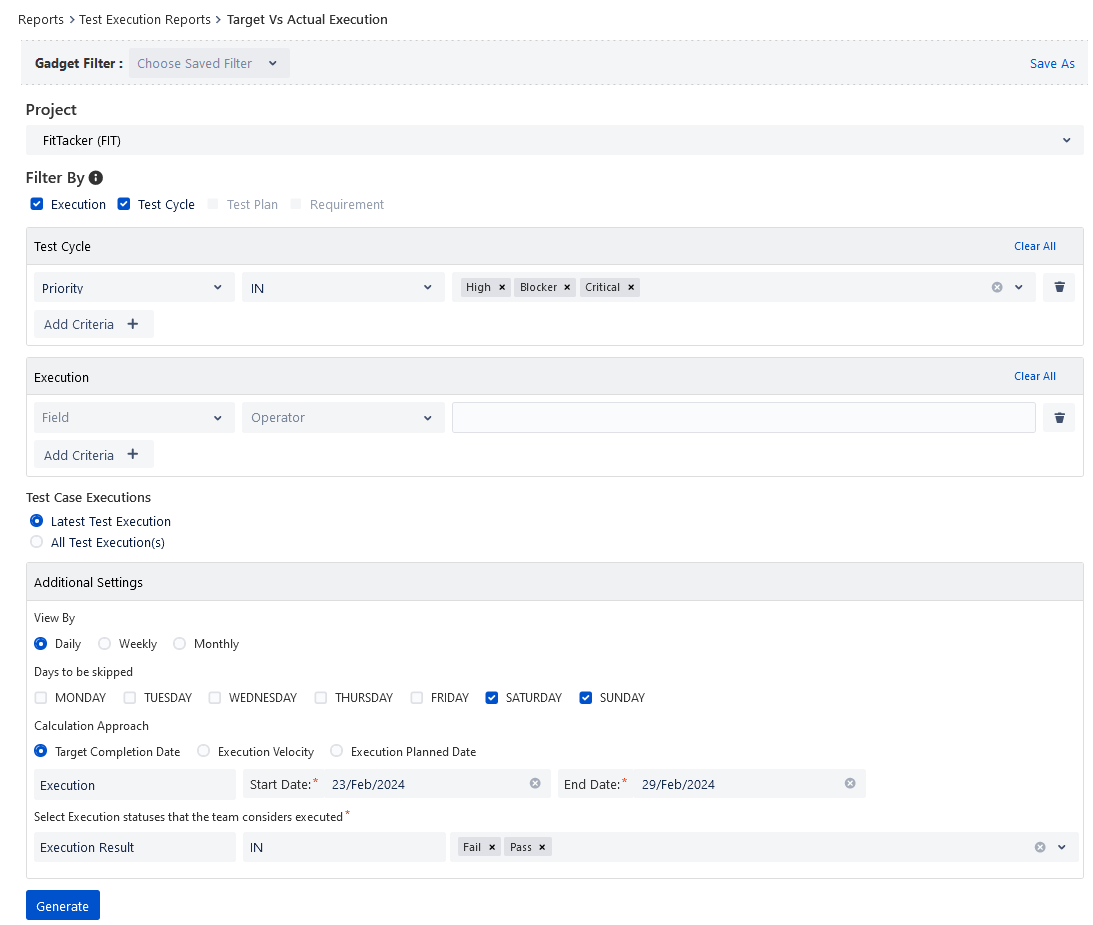

Follow the steps mentioned below to configure the report and generate it.

Step 1. Define Scope

The test execution scope is defined through the selection of the Project.

Note: The Target Vs Actual Execution report can be generated only for a single project.

You can apply filters to select the required test cycles to generate the report. You can apply filters like Test Cycle Keys, Folder Path, Fix Version, Sprint, Component, Labels, Priority, Assignee/Reporter, Planned Start Date/End Date, Test Cycle Custom fields, and Story Filter JQL to consider test cycle directly linked to Stories.

To select the required test executions to generate the report, you can apply filters like Execution Assignee, Environments, Builds, Execution Assignee, Executed By, Executed On, and Latest/All Test Executions.

Step 2. Additional Settings

  • View By: You can view the report for the frequency you select from (a)Daily (default) (b) Weekly (c) Monthly

    • Days to be skipped: If you select View By “Daily”, you get an option to skip the days the data of which you want to omit from the calculation.

Note: If the execution is carried out on the skipped days, such executions will be calculated on the next working day.

Frequency

The report can be generated for maximum up to

Daily

30 days

Weekly

90 days

Monthly

180 days

  • Calculation Approach: There are three Calculation Methods.

    • (A) Target Completion Date:

      • Execution Start Date and End Date

      • Select Execution Statuses that are considered as executed. You can select multiple Execution Statuses from the dropdown.

    • (B) Execution Velocity:

      • Execution Start Date

      • Mention the Test Execution Velocity per day. This is your planned execution velocity.

      • Select Execution Statuses that are considered as executed. You can select multiple Execution Statuses from the dropdown.

    • (C) Execution Planned Date:

      • Execution Planned Date (Start and End Date)

      • Select Execution Statuses that are considered as executed. You can select multiple Execution Statuses from the dropdown.

Click on the Generate button to generate the report.

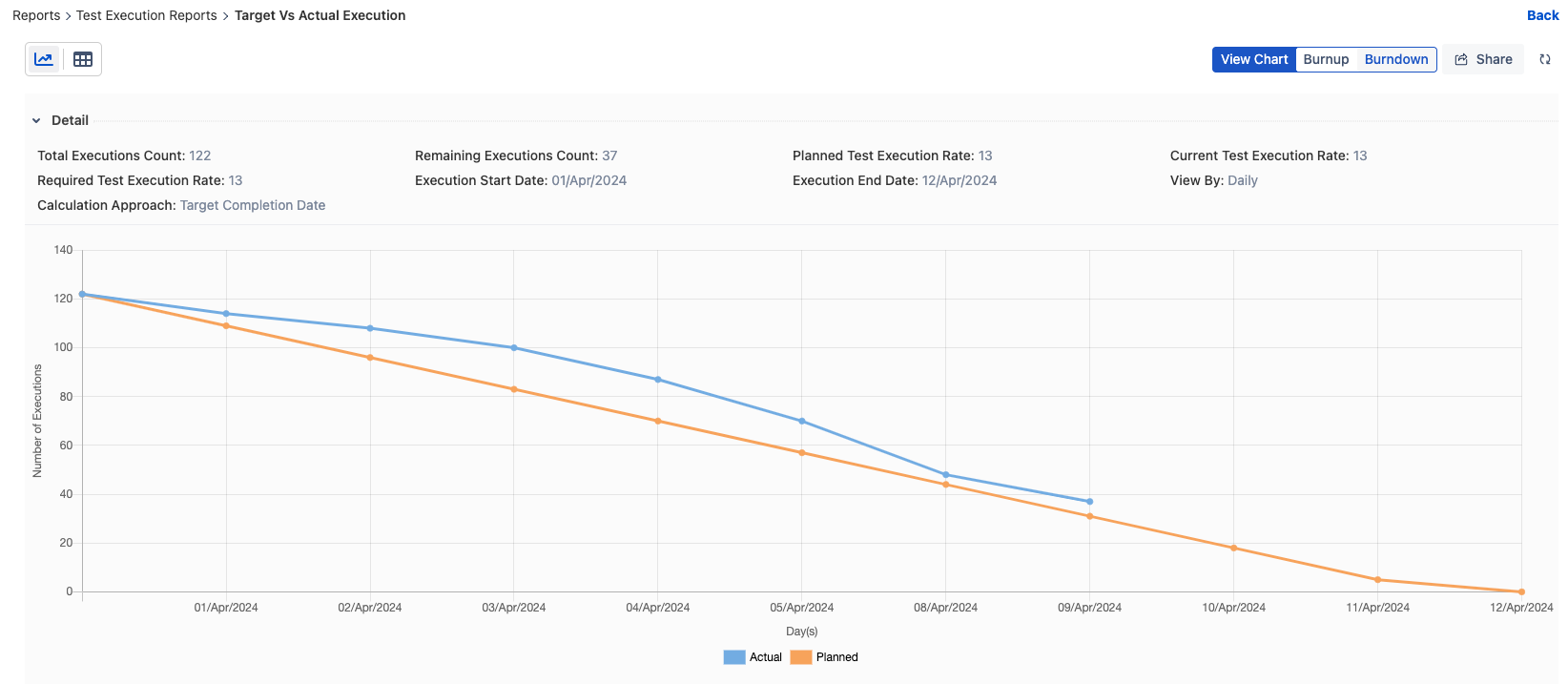

(A) Target Completion Date Report

The report calculates the average number of executions to be completed daily based on the total number of days used and the total number of executions.

  • Total Executions Count: Total test executions to be run.

  • Remaining Executions Count: Total test executions to be run - Test Executions already run

  • Planned Test Execution Rate: It is calculated based on the Start and End date (total number of days) and planned test executions.

Total Count of Planned Test Executions / Total Number of Days (excluding Skipped days)

  • Current Test Execution Rate: This is calculated based on the count of completed test executions and the total number of days required for the completion.

Total Executions / Total Number of Days (excluding Skipped days)

  • Required Test Execution Rate: Test Execution Rate required to complete the test execution as per the Execution End Date. It is calculated based on the remaining executions and total number of remaining days.

Remaining Executions / Remaining number of days

  • Execution Start Date: It is mentioned during the configuration of the report.

  • Execution End Date: It is mentioned during the configuration of the report.

  • View By: Selected during the configuration of the report.

  • Calculation Approach: It is selected during the configuration of the report.

A cumulative line chart is generated that displays the count of Planned Test Executions and Actual Test Executions. The cumulative Daily Count (i.e. The average count of test execution runs to be completed on each date as per the calculation) is displayed on the Y-axis and Dates are displayed on the X-axis.

  • Planned: It is calculated based on the Start and End date (total count of days).

Total Count of Planned Test Execution/Total Number of Days

  • Actual: It is calculated based on the daily total execution count (as per the executed date) that matches the selected execution statuses.

Burndown Chart (default)

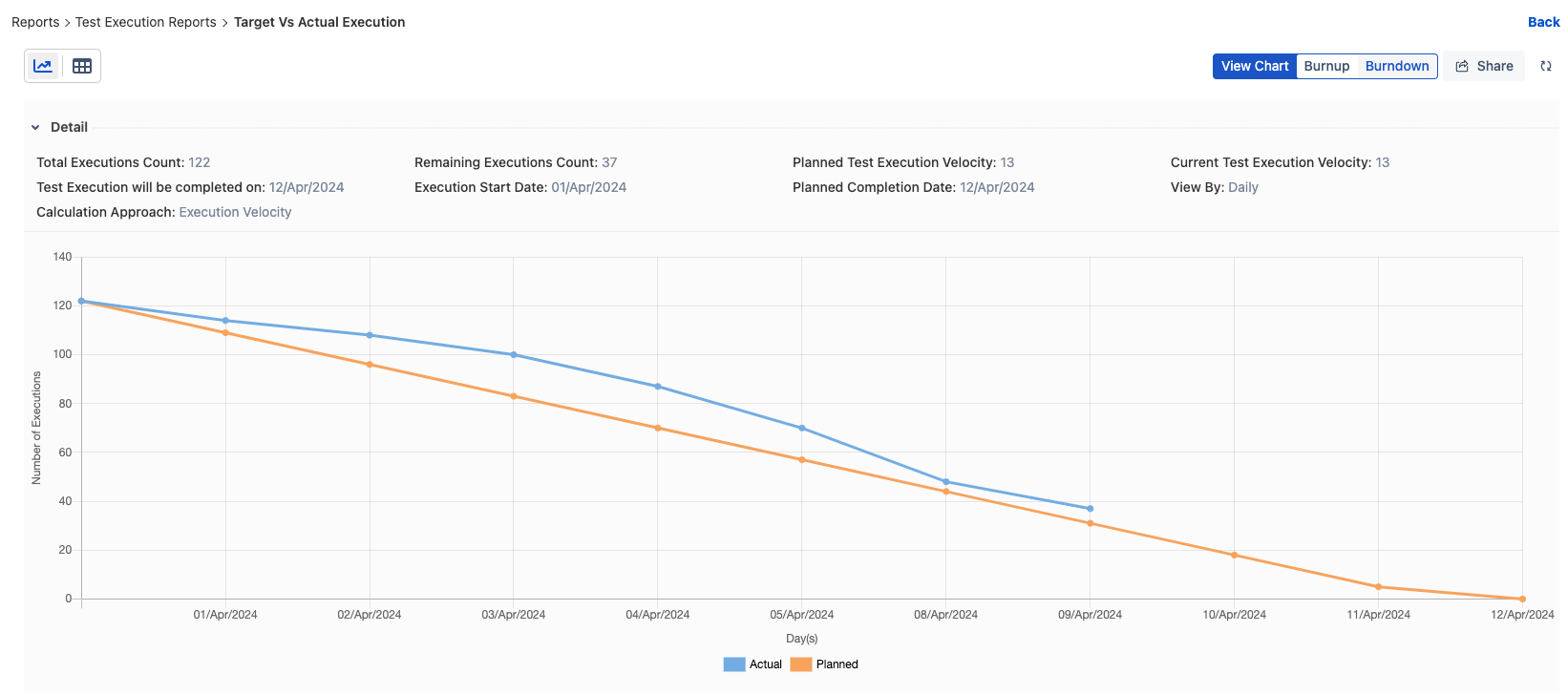

(B) Execution Velocity Report

Velocity is a measure of the progress of test execution by the QA team. It refers to the rate at which the QA team consistently runs the test executions. This predictive metric helps the QA Manager to determine the Test Execution Completion Date by which the defined scope could be achieved.

The report calculates the Test Execution Completion Date based on the Remaining Executions Count and Current Test Execution Velocity.

A cumulative line chart is generated that displays the count of Planned Test Executions and Actual Test Executions.

  • Total Executions Count: Total test executions to be run.

  • Remaining Executions Count: Total test executions to be run - Test Executions already run

  • Planned Test Execution Velocity: The Test Execution Velocity was mentioned during the configuration of the report.

  • Current Test Execution Velocity: It is calculated based on the actual test executions/Number of Days.

Total Actual Executions / Number of Days Required for the Execution

  • Test Execution will be completed on: The date is calculated based on the count of remaining test executions and Current Test Execution Velocity.

Current Date + (Remaining Test Executions / Current Test Execution Velocity) days

  • Execution Start Date: The date is mentioned during the configuration of the report.

  • Planned Completion Date: The date is calculated based on the Test Execution Velocity mentioned during the configuration of the report.

Start Date + Velocity applied by the user

  • View By: It is selected during the configuration of the report.

  • Calculation Approach: It is selected during the configuration of the report.

A cumulative line chart is generated that displays the count of Planned Test Execution Velocity and Actual Test Execution Velocity.

The cumulative Daily Count is displayed on the Y-axis and Dates are displayed on the X-axis.

  • Planned: It is calculated based on the user-provided daily execution velocity. The following formula is applied for calculation.

Total Planned Test Executions / Execution Velocity

  • Actual: It is calculated based on the daily total execution count (as per the executed date) that matches selected execution statuses.

The cumulative line chart is generated accordingly and the end date is calculated based on speed.

Burndown Chart (default)

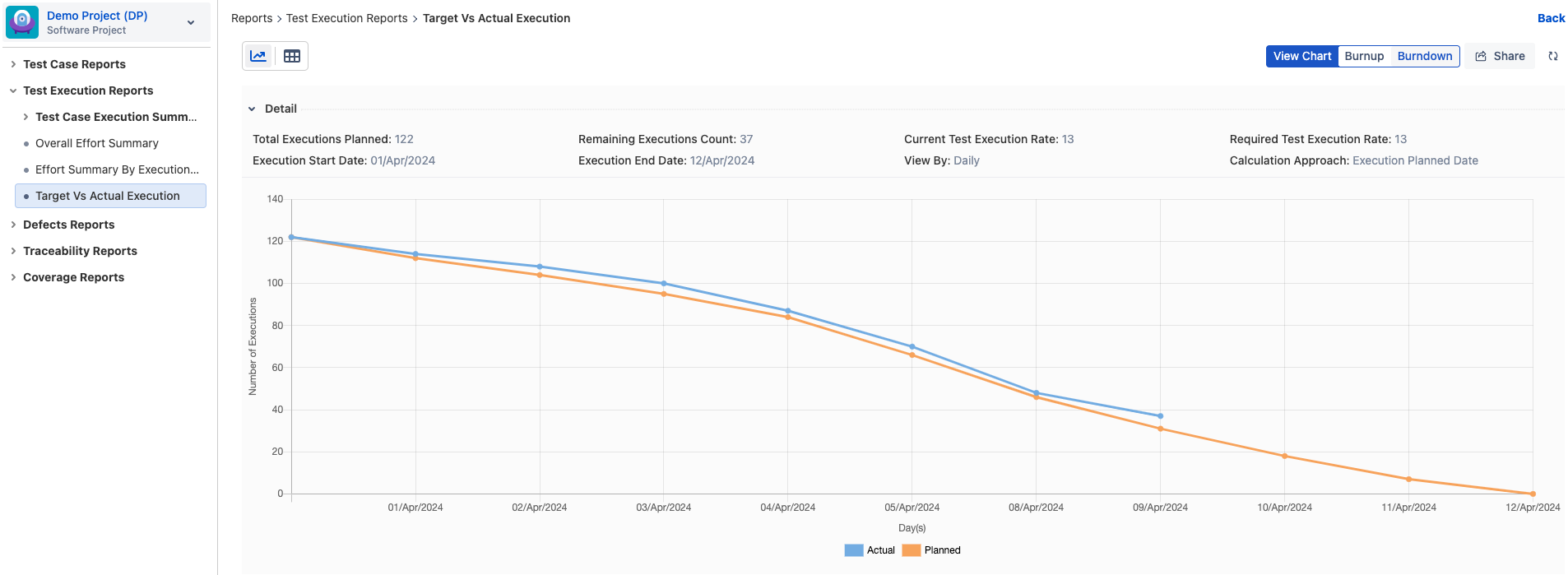

(C) Execution Planned Date

The Planned Date Graph displays the count of executions based on the planned execution for that specific day. The graph is cumulative, showing the total executions planned to date. When hovering over the counts, users can see the planned executions for that day and the overall total. This option exclusively considers test executions with planned dates falling between the Planned Execution Start Date and the Planned Execution End Date.

The generated cumulative line chart displays the count of Planned Test Executions and Actual Test Executions.

Note:

  • Only test case execution runs with a set planned date will be considered for the actual execution graph plot in the context of the Actual Date Graph. If a test execution does not have a planned date, it will be excluded from the calculation or consideration, even if it occurred during the selected period.

  • If executions are planned on skipped days then those executions will not be visible on the chart. This may result in the wrong interpretation of the report.

The following statistics are displayed in the report:

  • Total Executions Count: Total Planned Executions between the Start Date and the End Date.

  • Remaining Executions Count: Total Planned Executions - Test Executions already run.

  • Planned Test Execution Rate: It is calculated based on the Start and End date (total number of days) and planned test executions.

Total Count of Planned Test Executions / Total Number of Days

  • Current Test Execution Rate: This is calculated based on the count of completed test executions and the total number of days required for the completion.

Total Executions / Total Number of Days (excluding Skipped days)

  • Required Test Execution Rate: Test Execution Rate required to complete the test execution as per the Execution End Date. It is calculated based on the remaining executions and the total remaining number of days.

Remaining Executions / Remaining Number of Days

  • Execution Start Date: It is mentioned during the configuration of the report.

  • Execution End Date: It is mentioned during the configuration of the report.

  • View By: Selected during the configuration of the report.

  • Calculation Approach: It is selected during the configuration of the report.

The cumulative count is displayed on the Y-axis and the Date on the X-axis.

  • Planned: It is calculated based on the user-provided Execution Planned Start Date and End Date (excluding skipped days).

  • Actual: It is calculated based on the daily total execution count (as per the executed date) that matches selected execution statuses. If a test execution does not have a planned date, it will be excluded from the calculation or consideration, even if it occurred during the selected period.

Burndown Chart (default)

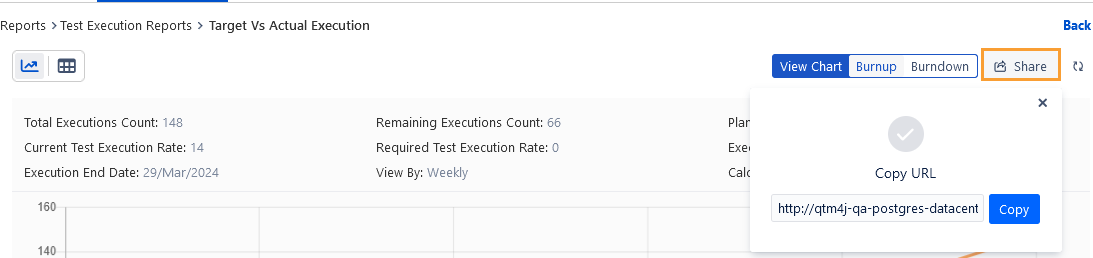

Users accessing the report through the shared URL can only view the chart. They can not modify the chart or share it further.
